Build Your Software Modernization Roadmap

Build a software modernization roadmap. Get a defensible framework based on failure data to set goals, estimate costs, and know when to abort.

Most software modernization roadmap advice starts with architecture, tooling, and migration patterns. It should start with money and risk.

A roadmap is a capital allocation and risk control document, not a vision document. If you treat it like an engineering wishlist, you’ll fund work that looks modern on slides and fails in production. That failure pattern is common.

CTOs are under pressure to move fast because software modernization spending is rising quickly. The U.S. Department of Defense’s FY25-26 Software Modernization Implementation Plan says modernization-related spending has grown at about 50% annually (DoD software modernization implementation plan). Pressure like that pushes bad decisions into portfolio plans. Teams start programs because the market says “modernize,” not because the economics and operating model justify the move.

For a business-side framing of that pressure, CloudOrbis has a piece on how to transform your business IT without pretending every legacy platform deserves a rebuild.

Why Most Modernization Roadmaps Fail

The standard roadmap template is optimistic. It assumes clear requirements, rational sequencing, stable dependencies, and an organizational alignment that rarely exists in practice.

A software modernization roadmap should start with a harder question than “how do we modernize?” Start with “what would make this a bad investment?” If your roadmap doesn’t answer that, it’s incomplete.

Roadmaps that hide risk

A serious roadmap does three things.

  • Defines the business reason: It ties the application to revenue protection, security posture, operational resilience, or strategic delivery capacity.
  • Surfaces failure conditions early: It identifies where data conversion, dependency breakage, compliance drift, or skills gaps can sink the effort.
  • Creates exit options: It gives leadership a rational basis to pause, narrow scope, or retire a system instead of blindly funding the original plan.

A clean migration diagram is not evidence. It’s often a sign the team hasn’t found the ugly parts yet.

A common mistake is treating legacy systems as technical debt only. Many are also process debt, documentation debt, and staffing debt. Moving them to Kubernetes or a hyperscaler doesn’t remove that burden and often hardens it into a more expensive operating model.

Think like an investor, not a platform team

A CTO should read a software modernization roadmap the way an investor reads an acquisition memo: where is the downside, which assumptions break first, and which systems deserve more capital versus containment or retirement?

Use this standard:

Decision lensBad roadmap behaviorDefensible roadmap behavior
Business case“Modernize because the stack is old”Tie work to specific business outcomes
Risk treatmentAssume issues will be found during deliveryName technical and operational failure modes up front
SequencingStart with the biggest, most visible systemStart where value is clear and blast radius is manageable
GovernanceQuarterly status theaterMeasurable gates with pause and stop criteria

A roadmap that can’t justify why a system should remain in the portfolio shouldn’t prescribe its future architecture.

The Modernization Kill Switch: When Not to Modernize

The best modernization decision is often to refuse, until the facts support action.

Data shows 67% of modernization projects fail due to technical pitfalls, and existing guides rarely give CTOs a defensible no-go framework, including when sunsetting beats migration or how to price risks like COMP-3 decimal precision loss in COBOL migrations (Martinelli on software modernization roadmaps).

Sometimes the best decision is to stop before you start. This checklist helps identify projects unlikely to succeed.

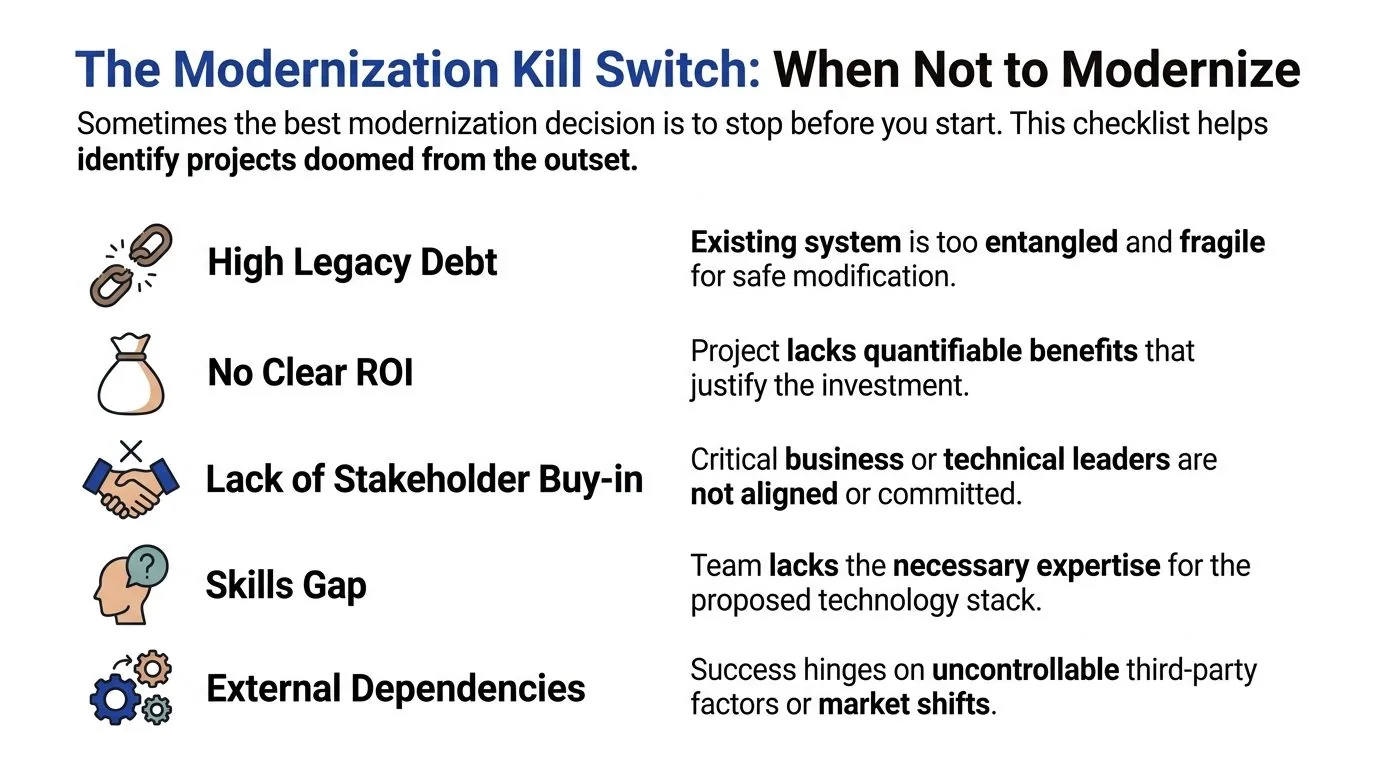

A checklist infographic titled The Modernization Kill Switch explaining when not to modernize software projects.
A checklist infographic titled The Modernization Kill Switch explaining when not to modernize software projects.

Five kill-switch conditions

1. The system is ugly but economically stable

If the platform is brittle yet cheap to run, serves a shrinking user base, and isn’t blocking strategic work, don’t force a modernization program just because the code offends your standards. Retain it, isolate it, and spend elsewhere. That is portfolio discipline.

2. You can’t state the return in operational terms

“No clear ROI” means you can’t explain what the business gets in concrete terms, not just that the finance slides are weak: reduced incident burden, faster release flow, stronger security controls, cleaner data handling, or decommissioned infrastructure.

“Cloud-native flexibility” alone is not a business case.

3. You’re about to preserve broken business logic in a new stack

Many modernization efforts fail because the technology changes while the underlying workflow stays irrational. Teams migrate every exception, workaround, and approval bottleneck into new services and APIs, and delivery doesn’t improve.

Kill or pause the project if the process owner can’t simplify the process before engineering starts.

Never modernize a workflow you haven’t challenged, or you will only automate dysfunction.

4. Critical stakeholders aren’t aligned on what must not break

Stakeholder misalignment is a delivery risk, not just a communication issue. If finance, operations, compliance, and product disagree on what data, controls, or customer behaviors are essential, the program will drift into rework and conflict.

Pause until you have written decision rights.

5. The skills gap is real and immediate

If the team lacks the capability to run the target stack, operate CI/CD, handle observability, or validate data conversion, the roadmap is unrealistic. This matters even more in legacy-heavy environments where the old system depended on tacit knowledge held by a handful of specialists.

A kill-switch matrix you can use in steering review

Use this before approving funding beyond discovery.

ConditionIf yesDecision
Low business growth, low user expansion, low strategic relevanceThe system isn’t a future differentiatorRetain or sunset
Benefits are described vaguelyNo measurable operating or business improvementPause
Core workflows are convoluted or disputedNew stack will encode old mistakesRedesign process first
Data conversion has high integrity riskFinancial or operational errors are unacceptableRun proof first or stop
Target-state skills are missingTeam can’t safely deliver or operateUpskill first or narrow scope

Where sunsetting beats modernization

Sunsetting wins when the platform’s remaining business life is shorter than the organizational pain of moving it. That usually shows up in systems with declining usage, duplicate capabilities, or reporting-only workloads that can be archived and accessed through simpler means.

It also applies when dependency chains are so tangled that extraction costs more than controlled retirement. In those cases, your software modernization roadmap should document a decommission path, not a migration path.

A CTO needs permission to say no. Without it, every old system becomes a candidate for investment, and the portfolio fills with projects that cost more than they return.

A 4-Lens Assessment to Quantify Risk and Value

Once a system survives the kill switch, assess it through four lenses rather than one. A technical audit alone misses the reasons programs fail in finance reviews, operating reviews, and post-cutover support.

The useful model is Technical Viability, Business Value Alignment, Organizational Readiness, and Financial Impact.

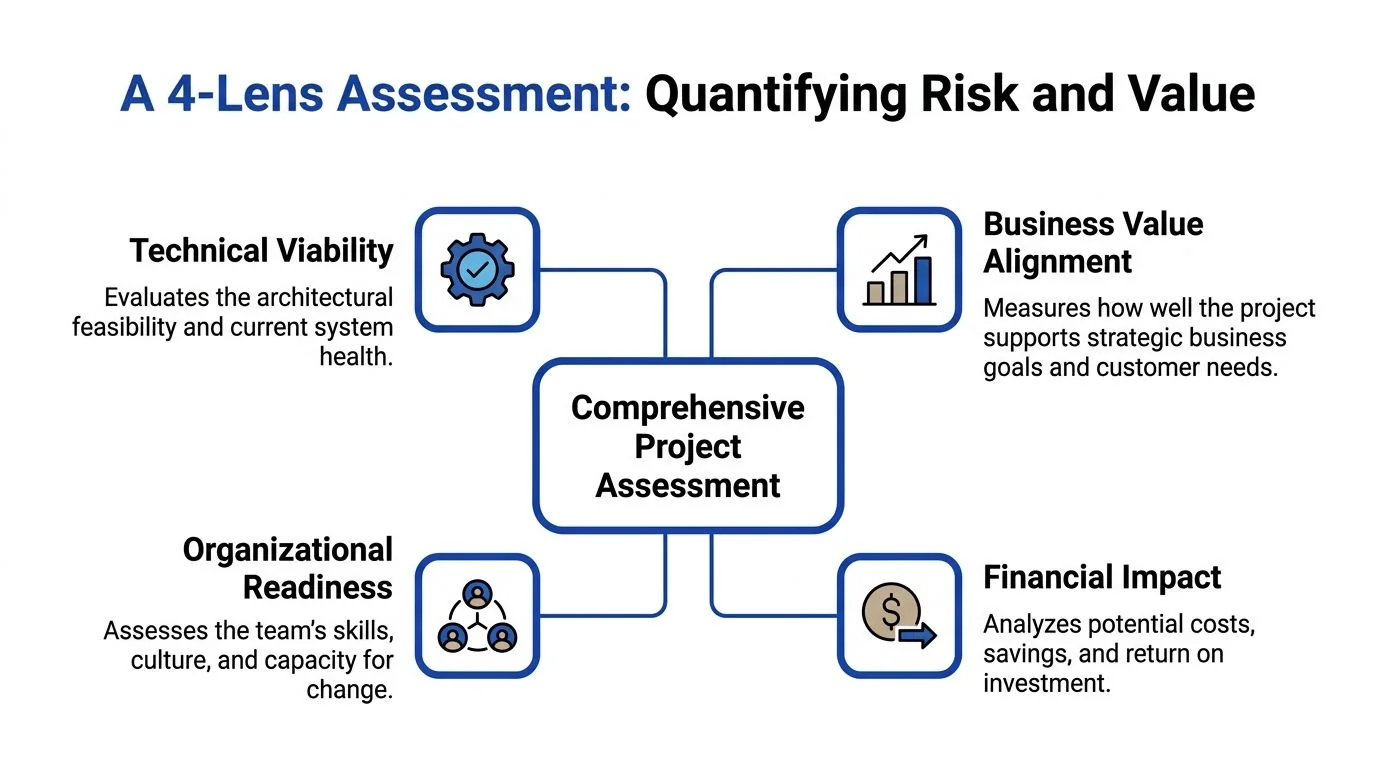

A diagram illustrating a four-lens assessment for quantifying project risk and value in business environments.
A diagram illustrating a four-lens assessment for quantifying project risk and value in business environments.

A solid roadmap links modernization work to business outcomes. Strong teams define outcomes like reducing checkout load time from five seconds to two seconds instead of saying “improve performance.” Leaders also prioritize cybersecurity, data management, and cloud migration, which means your assessment can’t be one-dimensional (application modernization roadmap guidance from CHI Software).

If you need a structured starting point for discovery, this legacy system risk assessment guide is a reference for building the inventory and dependency view.

Lens one: Technical viability

Technical viability is more than a code quality score. You need to understand dependency density, release friction, integration patterns, data coupling, testability, and operational fragility. Review codebase hotspots, performance logs, deployment paths, and interfaces with external systems. If one batch job, one file format, or one undocumented interface can break downstream reporting or customer workflows, that belongs in the first-page risk register.

Ask questions like:

  • Where are the hidden dependencies?
  • What data contracts are poorly documented?
  • Which interfaces can’t tolerate schema drift or timing changes?
  • What part of the stack only one engineer understands?

Lens two: Business value alignment

A system can be technically miserable and still worth preserving. Another can be elegant and still irrelevant.

Tie the platform to business outcomes that matter now, such as security control improvements, better data management, faster product change, reduced infrastructure drag, and cleaner compliance evidence. If the system doesn’t support a current strategic objective, it drops in priority no matter how emotionally attached the organization is to fixing it.

If you can’t connect a technical milestone to a business result, the work isn’t ready for funding.

Lens three: Organizational readiness

Many roadmaps assume the current team can deliver and operate the future state because the org chart says “platform,” “cloud,” or “DevOps.” Assess actual readiness instead:

  • Skill coverage: Who can build it, run it, secure it, and troubleshoot it?
  • Decision velocity: How quickly can product, architecture, and compliance resolve tradeoffs?
  • Change tolerance: Can the business absorb phased releases, retraining, and process changes?
  • Ownership clarity: Who owns post-cutover incidents and technical debt retirement?

If ownership is unclear before migration, it will be unclear after it.

Lens four: Financial impact

Go beyond implementation cost. Include run-state economics, support burden, internal time, cutover risk, rework probability, and the cost of delay on other priorities.

Use this lens to compare realistic alternatives:

OptionFinancial postureTypical use
RetainLowest immediate spend, ongoing dragStable systems with acceptable risk
ReplatformModerate spend, targeted efficiencyViable core logic with outdated runtime or infra
Refactor or rearchitectHigher spend, bigger operating changeStrategic systems with clear future value
SunsetSpend shifts to retirement and data handlingDeclining or redundant systems

A software modernization roadmap is defensible when all four lenses agree. If one lens says no, escalate it instead of burying it in appendix slides.

Setting Metrics and KPIs That Survive Scrutiny

Most modernization KPIs are too soft to govern anything. “Improve reliability,” “increase agility,” and “boost developer productivity” are aspirations, not metrics. Use metrics that can trigger intervention.

Monitoring is a required roadmap step. Effective programs track KPIs such as system uptime above 99.5%, development velocity measured in story points per sprint with ±15% variance, and business impacts like 15–35% year-over-year infrastructure savings. That matters because 67% of efforts derail due to unmonitored deviations (LeanIX application modernization roadmap guidance).

Track leading indicators before lagging outcomes

Lagging indicators tell you whether the migration eventually worked. Leading indicators tell you whether it’s going off track now. Use both.

Metric CategoryKPITargetIndicator Type
System performanceSystem uptime>99.5%Lagging
Development executionStory points per sprint variance±15% varianceLeading
Quality and stabilityPost-deployment defect rate<5%Lagging
Business impactInfrastructure savings15–35% YoYLagging

They are not vanity numbers: they show whether the team can deliver predictably, whether production quality is holding, and whether the business case is materializing.

Ban vague goals from steering reviews

If a program says it will “improve performance,” force specificity. Use the earlier example: reducing checkout load time from five seconds to two seconds. That is governable and links engineering work to user experience and commercial outcome.

Apply the same standard elsewhere:

  • Security posture: Define which controls, exposures, or audit pain points the work removes.
  • Data management: Specify which data quality, lineage, or access problems get fixed.
  • Cloud migration: State what operating capability improves, not just where workloads move.

If a KPI can’t embarrass someone in a monthly review, it won’t change behavior.

Build the dashboard for intervention

A useful dashboard shows trend, threshold, and owner. Don’t overload executives with raw observability feeds; give them what they need to decide:

  • Red thresholds: Explicit breach conditions for uptime, defects, or delivery stability.
  • Owner by metric: One accountable leader for each KPI.
  • Action state: Continue, intervene, pause, or rescope.

Run monthly tactical reviews against those metrics. If development velocity blows past the allowed variance or defect rates drift, adjust scope before the roadmap fails under optimistic assumptions.

Separate health metrics from outcome metrics

Teams often confuse system telemetry with modernization success. CPU curves and deployment counts matter, but they are not the business case.

Every technical KPI should map to one of these questions:

  1. Does it reduce operating risk?
  2. Does it improve delivery reliability?
  3. Does it produce a measurable business effect?

If the answer is no, drop it from the executive dashboard and keep it at the engineering level.

Mapping the Migration From Big Bang Failures to Iterative Wins

Big-bang replacement is still the most tempting migration strategy. It looks decisive, easy to explain, and clean on a roadmap. It also fails often.

A modernization roadmap should favor iterative execution. That approach reaches 70–80% success rates, compared with 33% for big-bang efforts, and can deliver up to 74% lower hardware, software, and staff costs when teams start with small pilots and scale incrementally (Evinent on application modernization roadmap execution).

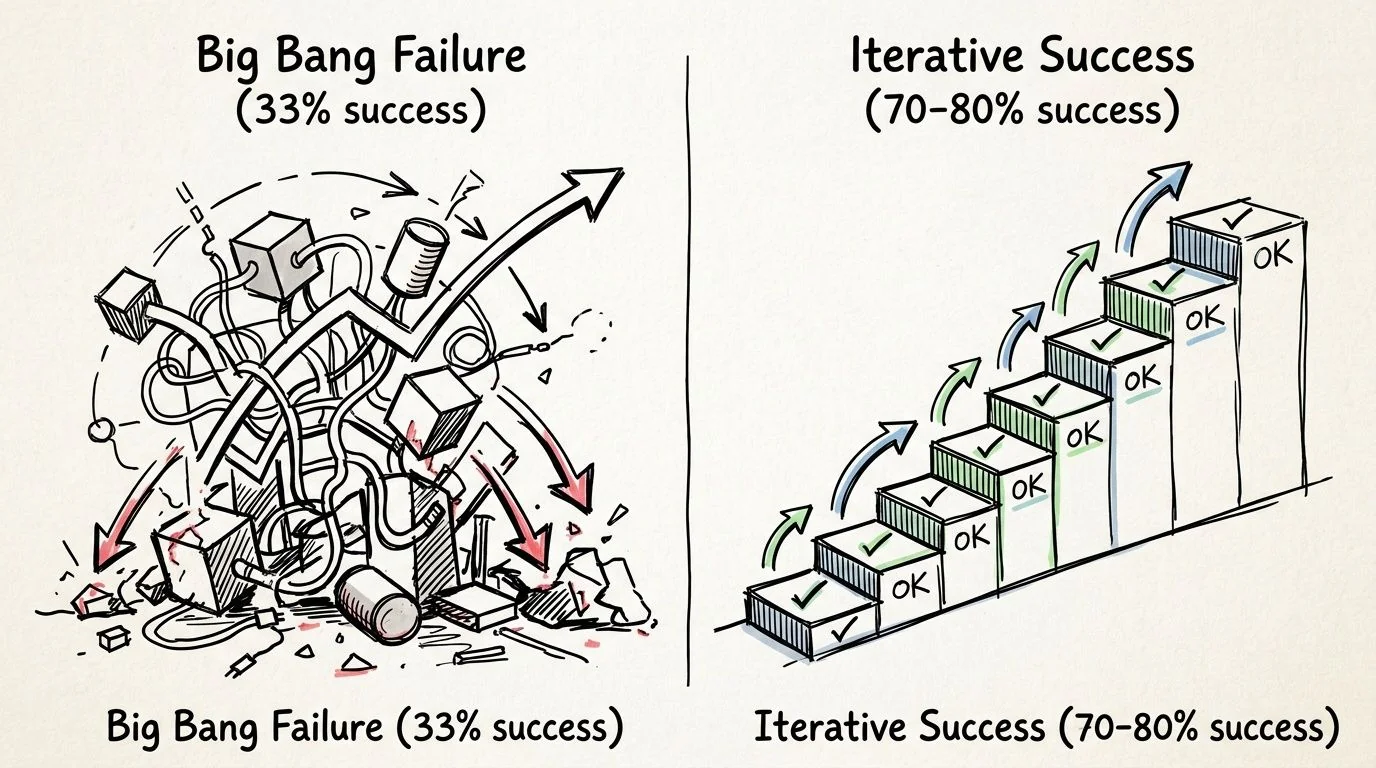

A comparison illustration showing a chaotic, unsuccessful big bang approach versus a structured, successful iterative development process.
A comparison illustration showing a chaotic, unsuccessful big bang approach versus a structured, successful iterative development process.

Choose the migration pattern by risk, not fashion

A rehost, replatform, refactor, or replace decision should come from the assessment, not from the cloud team’s preferences or a board deck that wants the word “AI” near the architecture diagram.

The table summarizes the patterns:

PatternWhat it’s good forWhat usually goes wrong
RehostFast infrastructure exitCarries old performance and operating flaws into the new environment
ReplatformModerate improvement without rewriting core logicUnderestimates integration and runtime constraints
Refactor or rearchitectLong-term agility for strategic systemsScope expands when boundaries were never defined
ReplaceEscaping dead-end softwareBusiness fit and process parity are often overestimated

The common error is overcommitting to refactor or replace before the organization proves it can execute smaller cuts safely.

Start with a pilot that can teach you something

Your first move should be a low-risk, high-learning pilot. Pick an application or module with real business relevance but acceptable blast radius. Use it to validate deployment automation, data movement, rollback logic, support ownership, and user acceptance.

Teams can borrow from broader product planning discipline here. Refact's product roadmap insights stress sequencing, validation, and learning loops.

For teams building a phased approach around legacy constraints, this guide to incremental legacy modernization follows the same principle: prove the path before scaling the spend.

Use a strangler approach whenever boundaries allow it

If the system architecture gives you even partial seams, exploit them. Put a facade in front of the legacy platform, route narrowly defined functions to modern services, and expand over time.

That reduces two risks at once: it limits cutover shock and exposes process and data issues earlier.

This walkthrough is worth watching before you decide sequencing and architecture boundaries:

What iterative execution changes operationally

An iterative software modernization roadmap forces discipline:

  • Pilot first: Validate testing, deployment, and rollback under real conditions.
  • Scale in slices: Move a capability, not an empire.
  • Keep feedback tight: User reaction and support tickets should influence the next increment.
  • Review architecture quarterly: Roadmaps that don’t adapt become obsolete.

Big-bang programs fail because they hide risk until the point of maximum commitment. Iterative programs surface risk while it’s still cheap to correct.

Budgeting for Reality and Selecting the Right Partners

Most modernization budgets price the migration work but not the organizational disruption required to absorb it.

A real budget must include internal engineering time, architecture review, security review, test automation, release management, data validation, training, temporary productivity loss, and contingency for ugly legacy surprises. If your estimate only includes vendor effort and cloud spend, it is a partial invoice, not a business case.

Build a total cost of modernization model

Use four buckets.

Delivery cost. External services, internal engineering, architecture, QA, and program management.

Transition cost. Dual running periods, cutover support, retraining, and process adaptation across operations, compliance, and product teams.

Risk reserve. Budget held for dependency discovery, data issues, rework, and rollback scenarios.

Run-state cost. The cost to operate the target platform after go-live, including tooling, support coverage, observability, and security operations.

A budget that ignores transition and run-state economics tends to approve projects that look affordable but cost more after modernization than before.

Cheap migration plans often create expensive operating models.

Partner selection as risk underwriting

A generic RFP and references won’t solve the problem: sales teams are polished, and delivery teams determine your outcome.

When evaluating partners, insist on evidence in five areas:

  • Relevant migration path experience: Mainframe, Java monolith, Oracle Forms, custom .NET estate, data platform, or security stack. Specificity matters.
  • Team continuity: Ask who will deliver, not who appears in the pitch.
  • Failure transparency: Request examples of troubled programs and what the partner changed.
  • Validation method: How they handle dependency mapping, data integrity checks, rollback design, and production cutover.
  • Commercial alignment: Tie payment and governance to measurable milestones, not vague effort consumption.

Market intelligence helps at this point. Software Modernization Intelligence tracks implementation partners across migration paths and focuses on failure analysis, cost transparency, partner specialization, and when not to buy. That is a more useful input than generic analyst positioning if you’re trying to understand execution risk rather than branding.

Contract for outcomes, not motion

If the statement of work rewards activity, you’ll get activity. Contract around gates that matter:

Contract areaWhat to require
DiscoveryValidated dependency map, risk register, and recommendation set
PilotWorking slice in production-like conditions with rollback proof
Scale phaseDefined KPIs, release cadence, and ownership model
CutoverAcceptance criteria tied to business continuity and support readiness

You also need a termination path. If the partner can’t meet quality, transparency, or milestone discipline, your contract should let you stop without subsidizing failure.

The right roadmap has a stop clause

A mature software modernization roadmap says what you’ll modernize, how you’ll migrate, and which partner you’ll hire. It also states the conditions under which you will pause, narrow, or stop.


If you’re building a software modernization roadmap now, do three things this quarter. Write the kill-switch criteria before funding delivery. Score every target system through the four assessment lenses. Then approve only one pilot that has measurable KPIs, explicit rollback logic, and a named owner for post-cutover operations.
